Become a Faculty Member with the FLEAP Program

Run a FLEAP Program

The Education Abroad office supports UCR faculty and departments in developing faculty-led summer programs in other states or countries. We aim to collaborate with you and assist in every step as you plan and coordinate a high-impact experiential program. Read more about our summer programs on Inside UCR!

This webpage covers a timeline from idea to departure, and contact information, funding, and frequently asked questions about teaching a summer Faculty-Led Education Abroad Program (FLEAP). FLEAPs are programs:

  • Designed and led by UCR faculty from any academic department
  • Runs in the summer term
  • Hosted for 2-5 weeks, typically in another country
  • Open to undergraduate and graduate students at UCR and other universities
  • Often include 8 units of summer courses; non-credit, fieldwork, and research possible

What are the benefits of running a FLEAP?


Faculty Benefits

  • Expand your global network.
  • Provide students with an extraordinary education experience.
  • FLEAP travel compensation includes:
    • Teaching salary and travel costs such as per diem.


Student Benefits

  • Broaden student interest in a particular field.
  • Widen understanding of the world around them.
  • Encourage students to take more courses in your department, increasing student retention and graduation rates.

Are you interested in leading a FLEAP?

Please complete a proposal


Deadline to submit a Summer 2027 FLEAP proposal:

Deadline: March 27, 2026

Proposal

Attend an Info Session

How to Get Started as FLEAP Faculty

UCR faculty should take the first step at least 20 months before a program departs. We need this much time to prepare itineraries with third-party providers, finalize budgets, sign the required paperwork, and recruit a minimum of 12 students who pay deposits. Info Sessions are scheduled if you'd like to learn more or ask questions in person.


Timeline

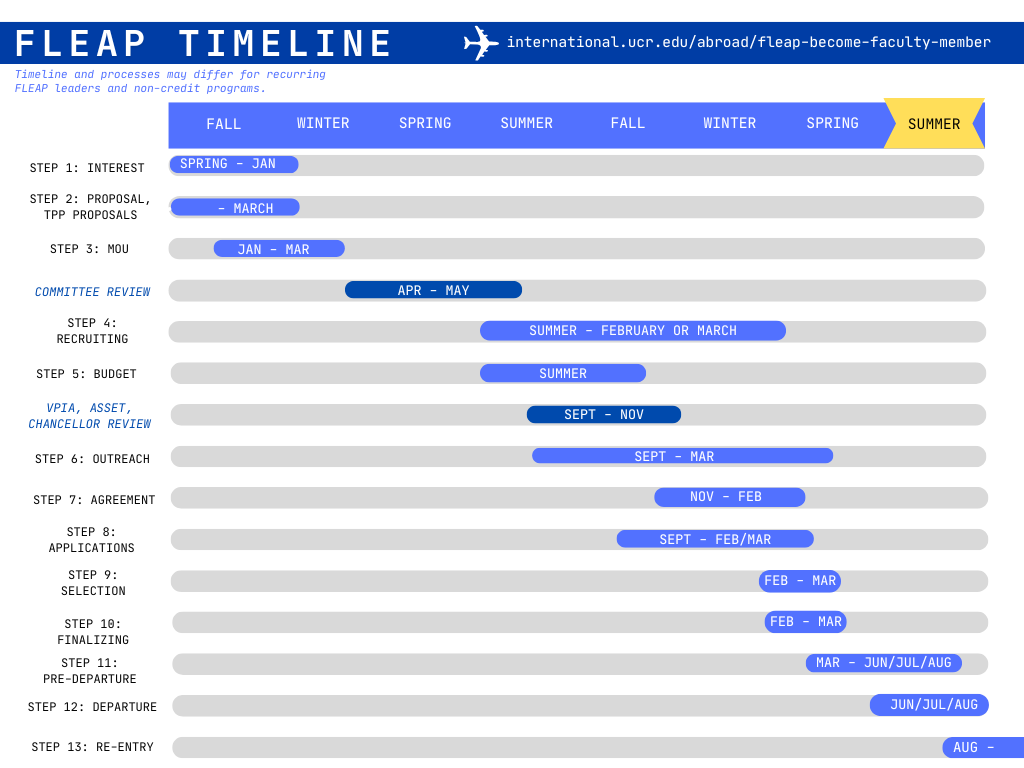

FLEAP timeline (revised January 2026)

Click a card below to display more information.

A committee will review your proposal after submission. Then, the Education Abroad office will announce the approved proposals.
In some cases, there is a revise and resubmit process.

For Approved FLEAP Programs:

Questions?

Please schedule a meeting with Sonja Lind, the Assistant Director of Education Abroad, or email sonja.lind@ucr.edu.

Or email Professor Robert McKee, the Campus Faculty Director of Education Abroad, at robert.mckee@ucr.edu.

Attend an Info Session

Frequently Asked Questions

Contacts

Jun Wang

Jun Wang

Assistant Provost

jun.wang@ucr.edu

Sonja Lind

Sonja Lind

Assistant Director of Education Abroad

sonja.lind@ucr.edu
Schedule a meeting
Book a classroom visit

Rob McKee

Robert McKee

Campus Faculty Director of Education Abroad

Assistant Teaching Professor, Bioengineering
VP International Affairs Admin

robert.mckee@ucr.edu



Carmen Rivera

Carmen Rivera

Business Officer

Financial and Administrative Solutions Team

Upcoming Events

2026 FLEAP Info Sessions

These sessions are for UCR faculty designing Faculty-Led Education Abroad Programs (FLEAP) in 2027.

Jan 26 with Rob | 12:15-1:45 pm | SSB 2201
Jan 29 with Sonja | 12-1:00 pm | Zoom
Feb 2 with Rob | 12-2:00 pm | SSB 2201
Feb 10 with Sonja | 12-1:00 pm | Zoom
Feb 26 with Sonja | 12-1:00 pm | Zoom
Mar 2 with Rob | 12-2:00 pm | SSB 2201
Mar 10 with Sonja | 12-1:00 pm | Zoom
Mar 16 with Rob | 12-2:00 pm | SSB 2201

Summer Social Hour (Former Event)

Meet off-campus with other UCR faculty and learn about UCR faculty-led education abroad programs (FLEAP). Attendees pay for food or a beverage of their choice.

Fri. Sept 27th, 3-5:00 pm

Food Lab
3605 Market St, Riverside

Meet at the red tables outside Wilson's Bar.

Fall Social Hour (Former Event)

Meet off-campus with other UCR faculty and learn about UCR faculty-led education abroad programs (FLEAP). Attendees pay for a hot beverage of their choice.

Thur. Dec 12th, 2-4:00pm

Arcade Coffee Roasters - Canyon Crest
5225 Canyon Crest Dr, #17A, Riverside

Frequently Asked Questions

Frequently asked questions about UCR Faculty-led Education Abroad Programs (FLEAP)

  • Students who prefer FLEAPs may:

    • Have limited time or resources to study abroad for a quarter or year (for example, they may work full-time)
    • Enjoy group programs with other students and you, the UCR faculty
    • Earn UCR summer credits, allowing them to attend as a graduating student
    • Use their federal, state, and institutional financial aid
  • You (and an optional TA or co-faculty) will teach eight units, typically two summer courses.

  • Courses already pre-approved in the UCR course catalog. You can teach courses which appeal to a broad number of students across disciplines (i.e., breadth courses) or teach courses which are required for the major. Faculty who have run past programs have offered one course along with a second 190 course that complements that first course.

  • Yes, your chair approves the courses you will teach, and can help you strategize on which courses could attract the most students.

  • Please review the third-party providers listed here: international.ucr.edu/abroad/fleap-third-party-providers. Contact information is listed there.

    Some providers we have worked with in recent years:

  • The UCR Education Abroad office under International Affairs supports faculty leaders. Together, we'll also work with the following campus units:

    • Your academic department
    • UCR Summer Sessions
    • Registrar
    • Financial Aid
    • Student Business Services
    • Student Health Services
    • Office of Title IX
    • Risk Management
    • Environmental, Health & Safety (EH&S)
    • Student Conduct & Academic Integrity Programs (SCAIP)
  • A teaching assistant is optional and will depend on the number of students. Note that many third-party providers offer on-site ground support, assistance, and educational services such as guest lecturers and classroom spaces.

  • To run a program, we require a minimum of 12 students with paid deposits and complete applications.

    If you have fewer than 12 students, your program may be canceled, or your department can agree to cover the budget shortfall.

    Note that FLEAP programs are typically capped at 20 students per faculty so as to keep things manageable and allow for more student interactions.

  • If you have fewer than 12 students, your program may be canceled.

    Alternatively, you may ask your department to cover the budget shortfall.

  • Summer Sessions appoints you as a summer faculty and pays you according to their policies. Please contact Summer Sessions Director Leonard Taylor for additional information.

    Student program fees will also cover the cost of your travel.

  • Student program fees cover lodging, ground transportation, per diem, and more. Program fees also cover your airfare and Summer Sessions pays your teaching salary.

    Some faculty choose to buy a group flight for their students, but this is up to you. Students can buy their own flights through Student Universe or other travel websites.

  • You are the faculty leader and can choose a location you know well, have ongoing research interests, and/or complements the courses you teach.

  • Our Education Abroad staff would be happy to help with any questions. We can also review your proposal prior to submission.

    Please schedule a meeting with Sonja Lind, the Assistant Director of Education Abroad, or email sonja.lind@ucr.edu or educationabroad@ucr.edu (general).
